Industrial Canteen Design: A 200-Seat Workers' Hall and a 120-Seat Staff Hall

Our design for a standalone canteen building on a manufacturing site: a 200-seat workers' hall with fixed benches, a 120-seat staff hall with loose furniture, a 16-seat directors' room, and behind the servery a kitchen, chapati and burning areas, store, pot wash and plate return. A canteen is planned as a flow, not as a room with tables in it.

Concept design. The layouts and views below are our own design work, produced by Hagerstone's design team. They are not a record of a completed project, and the client is not identified.

By Dhruv Agarwal · · 5 min read

Industrial canteen building in brick with a metal roof and a glazed entrance

The brief

A standalone canteen building on a manufacturing site, feeding three groups from one kitchen: the shop floor, the staff, and the management table. The plan had to work at the moment a shift breaks — which is the only moment a canteen is really tested.

A canteen is not a room with tables in it. It is a flow, and the plan either lets 200 people through it in twenty minutes or it does not.

Sizing: seats are set by the sitting, not the headcount

The building here carries 200 seats in the workers' hall, 120 in the staff hall and 16 at the directors' table. Those numbers come from the biggest group eating at once, not from total employment.

This is the decision that most often gets made backwards. A site with 600 people across three shifts does not need 600 seats; it needs enough for the largest shift, if that shift eats in one sitting. Stagger the break into two sittings and the hall halves — but the servery then has to move twice the trays in the same total time, which means a second serving line, more bain-marie length and more hand-wash points. The break pattern decides the building. Settle it before the plan, not after.

The flow, entry to plate return

One direction, never crossing itself:

  1. Enter and wash. Hand-wash areas sit at every entry — 3340 × 3040 mm at the staff entrance, 2090 × 2600 mm near the directors' end, and another at the workers' entrance. Put the basins inside the hall instead and the queue forms across the dining floor.
  2. Collect. Hot and cold bain-marie counters with a service counter between them.
  3. Sit. The halls sit directly off the servery, so nobody carries a tray past a queue.
  4. Return the plate. Plate collection, dish racks and pot wash are grouped together behind the servery, with a bin-dry zone and the garbage route leaving from the same back-of-house side.

The last point is the one that gets designed wrong most often. If the plate return is next to the serving queue, every person finishing a meal walks against every person starting one, twice a day, for the life of the building.

Circulation is drawn at 1.2 m for the internal passages, and a common pathway runs along the service side so kitchen traffic never enters a hall. Air curtains at the entries and flap curtains at the kitchen openings keep flies and kitchen heat out of the dining halls — cheap at construction stage, impossible to add gracefully later.

Three halls, three furniture strategies

HallSize on planSeatsFurniture
Workers' dining24150 × 9255 mm200Fixed bench tables with stools on a frame
Staff dining11961 × 12015 mm120Loose tables and chairs, plus high tables at the edge
Directors' dining11900 × 5000 mm16One long table, plus a lounge seating corner

The furniture follows how the room is used, not the status of the people in it. Fixed benches in the workers' hall mean nothing to move, nothing to go missing, and a floor that can be washed down in one pass. Loose furniture in the staff hall because that room is also used for briefings between meals. The directors' room is screened with slatted timber rather than walled off, so it reads as part of the same building.

A tuck shop of 2440 × 2000 mm sits between the halls, a cafe counter with high stools serves the break that does not need a tray, and drinking water coolers are placed at each hall rather than centrally.

Behind the servery

An Indian canteen kitchen needs more than a Western layout assumes, and this plan is specific about it: a chapati-making area with hot plates and a puffer, a burning area with burners and a rice steamer, a preparation area, a dry store with racks, a cutlery and crockery cabinet, and a separate pot wash with pot storage.

The gas bank sits outside the building, reached from the service side and agreed with the site's safety team — never a decision to leave to the kitchen contractor. A janitor's closet, a dorm room of 2785 × 2945 mm for the resident kitchen staff, and separate toilets for men (4700 × 3000 mm), women (3690 × 1680 mm) and the directors' end complete the back of house.

Finishes, and why they are dull on purpose

Every surface here is chosen to be washed: large-format floor tiles laid to fall, a brick dado up to sill level so trolleys and stools do not mark plaster, and concrete with grooves at the entrance so wet footwear has somewhere to lose its water.

The building is a sandwich-panel roof at lintel level on a simple frame, with clerestory glazing above the brick dado. That band of high glass is the quiet move in the whole scheme: it lights a deep hall all day without putting sun on the tables, so the lights stay off through the shift.

Related: vitrified tile · epoxy flooring · PEB roofing and wall cladding · pre-insulated duct

What to settle before construction drawings

  • The break pattern and the biggest sitting. Everything else is downstream of it.
  • The menu, honestly. Chapati and rice in quantity need different equipment, different extract and different serving lengths.
  • Serving lines: one or two. Two sittings almost always mean two.
  • The waste and delivery route, and where bins stand between collections.
  • Water supply and drainage capacity for the wash lines, which are the heaviest services load in the building.
  • Whether the dorm room is really needed, and if so, its access out of hours.
  • Gas bank position, agreed with the site safety team before the layout is frozen.

Taking it to site

We build the canteen as a single package — shell, interiors and services: industrial and factory construction · pre-engineered buildings · turnkey office fit-out · fit-out MEP coordination · factories and manufacturing

Planning a canteen for a plant? Send the site plan, the shift pattern and the biggest sitting. Talk to the design team.

The whole building on one plan

Dining halls to the left and bottom, servery and kitchen through the middle, back of house and toilets to the right. Every room dimensioned, which is what makes a seat count arguable.

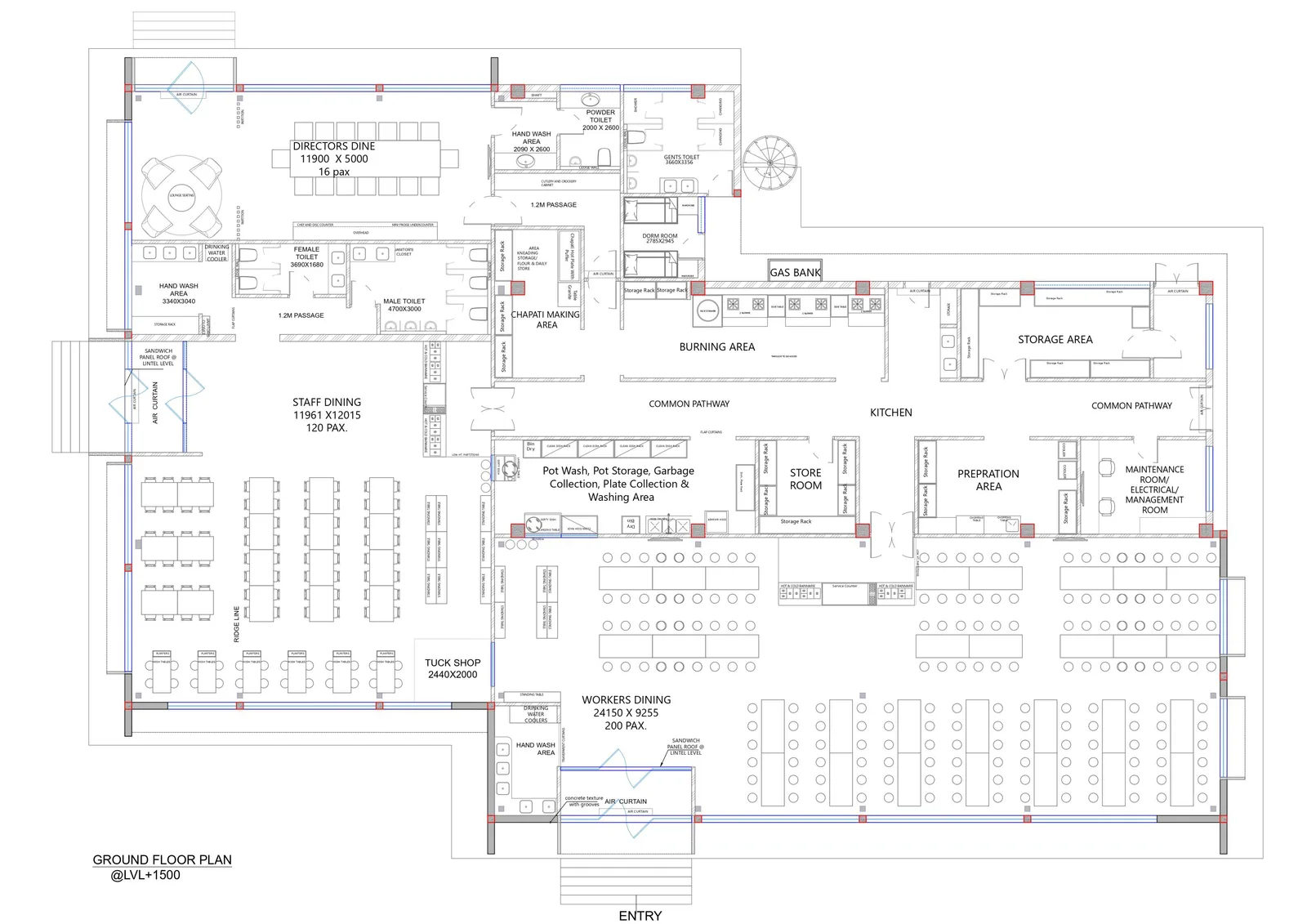

Annotated canteen floor plan marking dining halls, kitchen, wash areas and toilets
The whole building on one plan: 200-seat workers' dining, 120-seat staff dining, 16-seat directors' dining, kitchen, wash lines and toilets.

Three dining rooms, three furniture strategies

Fixed benches for 200, loose furniture for 120, and a screened room for 16 — all fed from one servery.

Workers' dining hall with fixed bench tables and stools under a metal roof
Workers' dining, 24150 x 9255 mm for 200: fixed tables and stools, nothing to move or lose. Indicative viewpoint.
Staff dining hall with rows of loose tables and chairs beside a vending machine
Staff dining, 11961 x 12015 mm for 120: loose furniture, so the room can be re-set. Indicative viewpoint.
Dining hall with clerestory glazing above a brick dado and a drinks chiller
Clerestory glazing above the brick dado lights the hall without putting glare on the tables. Indicative viewpoint.

Servery, cafe counter and tuck shop

The counters people actually queue at, and a standing cafe for a short break that does not need a tray.

Serving counter in timber and stone with a slatted screen dividing the seating beyond
Serving counter, with a slatted screen separating it from the quieter seating. Indicative viewpoint.
Cafe counter with high stools, pendant lights and a round table beyond
The cafe counter: a short break taken standing, away from the dining halls. Indicative viewpoint.

The directors' room

Sixteen seats and a lounge corner, screened from the staff hall rather than built into a separate wing.

Directors' dining room with a round table, slatted timber screens and panelled walls
Directors' dining, 11900 x 5000 mm for 16, screened rather than walled off. Indicative viewpoint.

The building

A standalone block in brick and metal sheet, with the service side facing away from the approach.

Side elevation of a canteen building with a brick wing and a rendered service block
The service block sits behind, with its own access for deliveries and gas. Indicative viewpoint.

Frequently asked

Seats are set by the largest number eating at once, not by total headcount. If 600 people work across three shifts and the biggest shift is 200, the workers' hall is sized for 200 — but only if they all eat in one sitting. Where the break is staggered, two sittings of 100 halve the hall and double the pressure on the servery, which then needs a second serving line. Decide the break pattern before the plan, because it changes the building.

One direction, and never crossing itself: enter, wash hands, collect from the servery, sit, then return the plate at a point that does not pass back through the queue. This design puts hand-wash areas at each entry, hot and cold bain-marie counters at the servery, and the plate collection and pot wash together behind it, with the garbage route leaving from the same back-of-house zone rather than through the hall.

Usually not in the same room, but they should eat the same food from the same kitchen. This plan has a 200-seat workers' hall, a 120-seat staff hall and a 16-seat directors' room, all fed by one servery. The split is practical — different break timings, different noise, different clothing straight off the shop floor — and it avoids the impression of a different standard of kitchen for different people.

The workers' hall takes fixed bench tables with stools on a frame: nothing to move, nothing to lose, and the floor can be washed down in one pass. The staff hall takes loose tables and chairs, because it is also used for briefings and training between meals. The furniture choice follows how often the room gets re-set, not the status of the people in it.

More than a Western kitchen assumes. This layout carries a chapati-making area with hot plates and a puffer, a burning area for burners and a rice steamer, a preparation area, a dry store with racks, a cutlery and crockery cabinet, and a separate pot wash with pot storage, dish racks and a bin-dry zone. The gas bank sits outside the building, reached from the service side.

Yes. Send the site plan, the shift pattern and the biggest number eating at once, and we will plan the halls, the servery and the back of house as one flow — then build it, including the shell if it is a new block.

Related

More in Our Designs

All Our Designs →

Planning an office or commercial project?

Tell us what you are planning. Message our team on WhatsApp, call us, or leave your number and we will call you back.

Request a callback
