Factory Canteen Design: 670 Seats on Two Floors, With a Training Centre

Our concept design for a two-floor canteen building on a manufacturing site: 670 dining seats in three halls, a kitchen with its own preparation, cooking, store and wash rooms, welfare rooms including a daycare and an occupational health centre, and a training centre upstairs. One plan, shown in five finish options.

Concept design. The layouts and views below are our own design work, produced by Hagerstone's design team. They are not a record of a completed project, and the client is not identified.

By Dhruv Agarwal · · 6 min read

Large canteen dining hall with saffron walls, painted grain and food murals, rows of white tables and saffron chairs

The brief

A canteen building on a manufacturing site, ground plus one, each floor 74.5 x 24 m and about 3,576 m² across the two. It had to feed the site at shift breaks, carry the welfare rooms a large workforce needs, and give the plant a proper place to train people.

The answer is two floors with two distinct programmes: dining, kitchen and welfare on the ground floor; a third dining hall and a training centre on the first. The furnished plans start from the existing building drawings. The training furniture upstairs is new.

Three halls, not one

HallFloorSeats
Dining hall AGround156
Dining hall BGround194
Upper dining hallFirst320
Total670

A single 670-seat room would be one long queue and one wall of noise. Splitting the seats across three halls means each one is a manageable size at a shift break, and each one gets its own servery wall, drop-plate point, dish wash and handwash. Nobody carries a tray from one hall into another, and the upstairs hall does not depend on food carried up the stair: it has its own pantry of about 16.1 x 6.5 m and its own wash.

On the ground floor the two halls sit either side of the entrance corridor, which also holds the stair and lift. People arrive in the middle of the building and turn left or right into a hall; they never walk through one hall to reach the other.

The flow: wash, serve, sit, return

The plan keeps one direction through every hall:

  1. Wash at a handwash room at the hall entrance, with an L-shaped run of basins on a steel frame and a matt floor laid to a drain.
  2. Collect at a stainless-steel servery along the hall wall, with the menu board and drinking water beside it, not in the queue.
  3. Sit at long tables in rows, loose chairs on a pedestal or frame base.
  4. Return at a dish-return hatch next to the handwash, not next to the servery, so people finishing a meal never walk against people starting one.

Behind the counter the kitchen is laid out the same way. Preparation (about 8.1 x 4.3 m) and cooking (about 8.1 x 3.8 m) sit side by side, with a wet store, dry stores, change rooms, a garbage room and a wash area around them. Food goes out through the servery hatch; plates come back through a separate return room with a scrape-sort-empty point, a three-bowl sink and drying racks, then leave through a clean door.

Related: factory canteen and amenity block planning · pantry and cafeteria fit-out

Welfare rooms on the ground floor

A canteen block on a large site is often where the welfare rooms go, because it already has water, drainage and footfall. This plan carries:

  • an occupational health centre (OHC) with a consultation desk, a curtained couch and its own toilets
  • a daycare with a feeding room and a child-height washroom off it
  • a ladies' rest room with WC and bath
  • staff change rooms and a driver rest room with its own WC and bath

Each wet room is separate, so the daycare washroom is never shared with a kitchen change room or a driver's bath.

The training centre upstairs

Half of the first floor is training, in two parts:

  • a product and TV gallery: a fixed display rail and screens along one wall, so trainees can see and handle the product they will be working on
  • a classroom with rows of tablet chairs facing a screen wall, and eight round tables behind for group work

The ceiling is a 600 x 600 mm grid with acoustic panels and regular LED panels, so a room full of people and a presenter stays intelligible. The display rail has concealed cabling and independent supports: screens and product samples are heavy, and their loads are coordinated with the structure rather than hung from the ceiling grid.

Related: acoustic design for offices · false ceilings and partitions

Five finish options, one plan

All five options keep the same halls, the same servery and the same wet rooms. What changes is the colour above the dado, the chairs, the tile banding and the mural theme.

OptionCharacter
01 Saffron and stoneSaffron walls, grey dado with green bands, grain-and-food murals
02 Earth and craftSand and sage, terracotta chairs, folk-art panels drawn from handloom and pottery
03 Coast storiesPeach walls, coastal murals, a saffron tile border at the top of the dado
04 Pistachio and coralCoral and green blocks in the tiles and chairs, a quieter wetland mural
05 Industrial worksGraphite and safety yellow, with line drawings of the plant's own work

The murals are "a story across the walls": a different chapter between each pair of openings, with quiet wall areas left clear so the hall does not feel busy. Dining walls show local life and shared meals; the training floor shows process, product and people.

Finishes that are easy to build and easy to clean

The specification is deliberately plain, so every option is built from the same materials:

  • Floor: grey and green Kota stone in the dry dining areas, colour-matched matt porcelain in the wet rooms
  • Walls: a 300 x 600 mm stock tile dado, with painted artwork above it. No intricate stone inlay, which would be slow to lay and impossible to patch
  • Setting out: whole rectangular modules, with the final setting-out taken from the surveyed room edges, so the cuts land where they are least visible
  • Signage: one family throughout, in painted metal with replaceable printed inserts, bilingual copy proofread before it is made

Wet rooms

Handwash rooms, toilets and the kitchen get repeatable, cleanable details: waterproofing turned up at the wall, sealant at every change of plane, a matt floor tile laid to fall towards the drain, tile borders aligned through corners, a flush transition at each doorway, and traps and fittings that can be reached and replaced. These are shown as schematic junctions; the falls, outlets and waterproofing are settled in coordinated working drawings.

Related: vitrified tile · flooring systems · office signage and wayfinding

What to settle before construction drawings

  • The break pattern and the largest sitting per hall, which confirms the seat split.
  • Kitchen equipment, LPG, drainage and exhaust. These need specialist coordination before the kitchen layout is fixed.
  • Store and small-room dimensions. Where the source plans conflict, the source room boundaries govern until a survey settles them.
  • Training intake size and the products on display, which set the display rail loads and the screen positions.
  • Signage copy, in both languages, proofread before fabrication.

Taking it to site

We build canteen and welfare blocks as one package, shell, interiors and services: industrial and factory construction · fit-out MEP coordination · factories and manufacturing

Planning a canteen or welfare block for a plant? Send the site plan, the shift pattern and the largest sitting. Talk to the design team.

Two floors, two programmes

Each floor is 74.5 x 24 m. Dining, kitchen and welfare on the ground floor; a third dining hall and the training centre above.

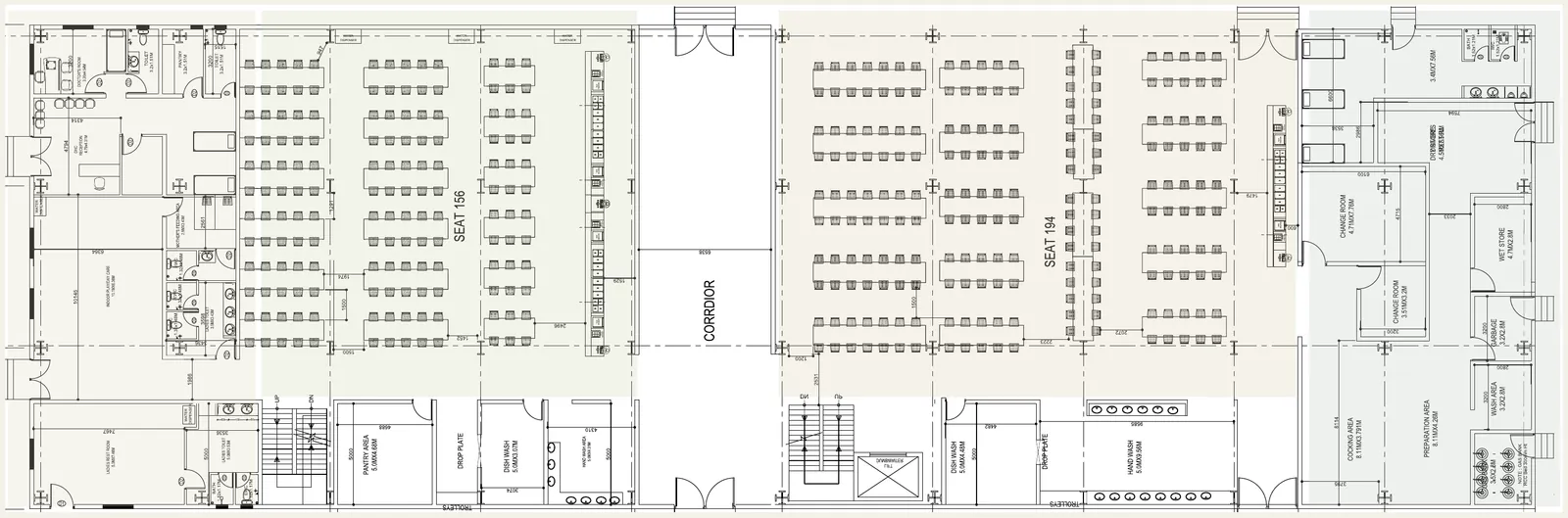

Furnished ground-floor plan of a canteen with two dining halls either side of a corridor, servery, kitchen and welfare rooms
Ground floor, 74.5 x 24 m: a 156-seat and a 194-seat hall either side of the entrance corridor, the kitchen at one end, welfare rooms at the other.

Furnished first-floor plan with a 320-seat dining hall, a pantry, a product gallery and a classroom with round training tables
First floor: a 320-seat dining hall over one half; over the other, a product gallery and a training room with classroom rows and round tables.

Option 01: saffron and stone

Saffron walls above a grey tiled dado, green banding in the floor and dado, and grain-and-food murals.

Material board with saffron paint, grey and green floor tiles, a white tabletop, a black pedestal base and saffron and grey chairs
Option 01, saffron and stone: grey floor with green banding, saffron walls above a tiled dado.

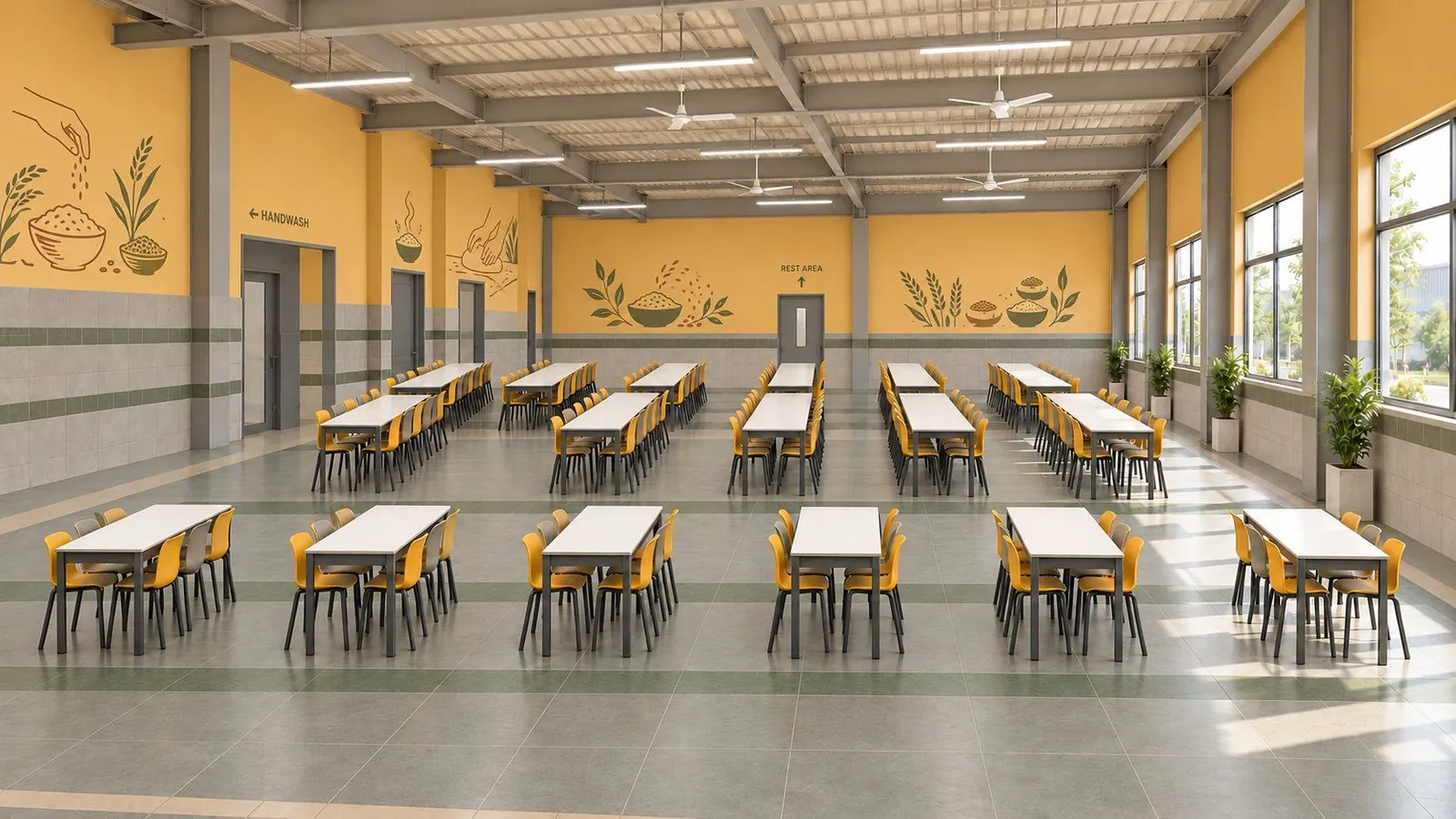

Large canteen dining hall with saffron walls, painted grain and food murals, rows of white tables and saffron chairs
Ground-floor dining hall: long tables in rows, murals above a 300 x 600 mm tiled dado. Indicative viewpoint.
Canteen servery with a long stainless-steel counter under a hanging SERVE sign, a menu board and a drinking-water point
The servery runs the end wall, with the menu and drinking water beside it rather than in the queue. Indicative viewpoint.
Canteen handwash room with an L-shaped run of basins, mirrors, soap dispensers and a dark matt floor with a drain
Handwash at the hall entrance: an L-shaped basin run on a frame, matt floor laid to a drain. Indicative viewpoint.

Option 02: earth and craft

Sand and sage, with terracotta chairs and folk-art panels drawn from handloom and pottery.

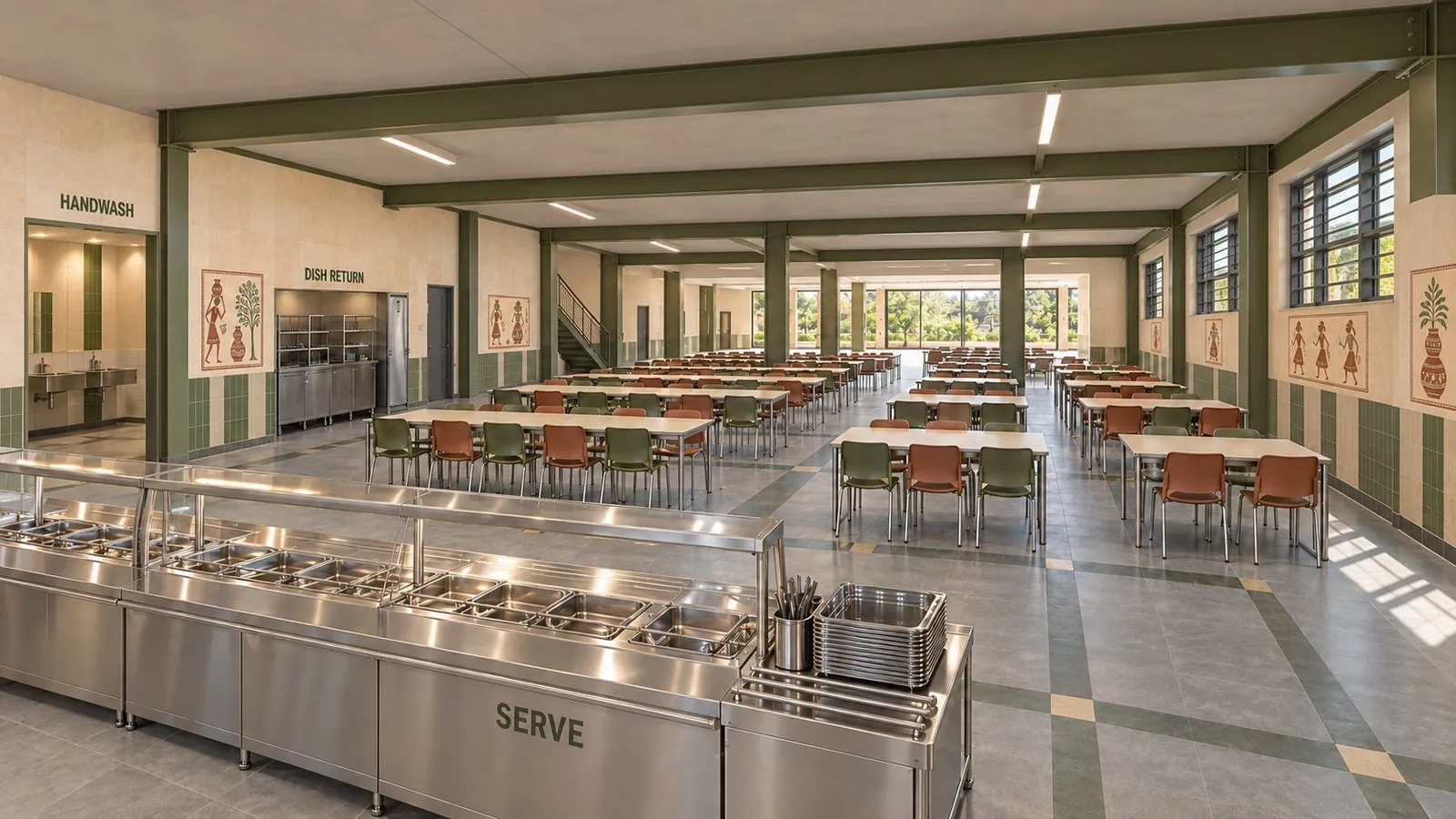

Canteen hall seen over a stainless-steel servery, with sage steel beams, green and terracotta chairs and folk-art panels
Dining seen from the servery, with dish return and handwash on the same side wall. Indicative viewpoint.

Option 03: coast stories

Peach walls with coastal murals, and a saffron tile border at the top of the dado.

Canteen hall with peach walls, coastal murals, a servery counter in the foreground and handwash and return openings
Option 03, coast stories: handwash and plate return open off the hall next to the servery. Indicative viewpoint.

Option 04: pistachio and coral

The colour moves into the tiles and chairs, with a quieter wetland mural above.

Canteen hall with pistachio walls, a wetland mural, coral and green chairs and a long servery counter
The same servery wall in option 04: one plan, five ways to finish it. Indicative viewpoint.

Kitchen, servery and dish return

The rooms behind the counter, laid out so food goes out one way and plates come back another.

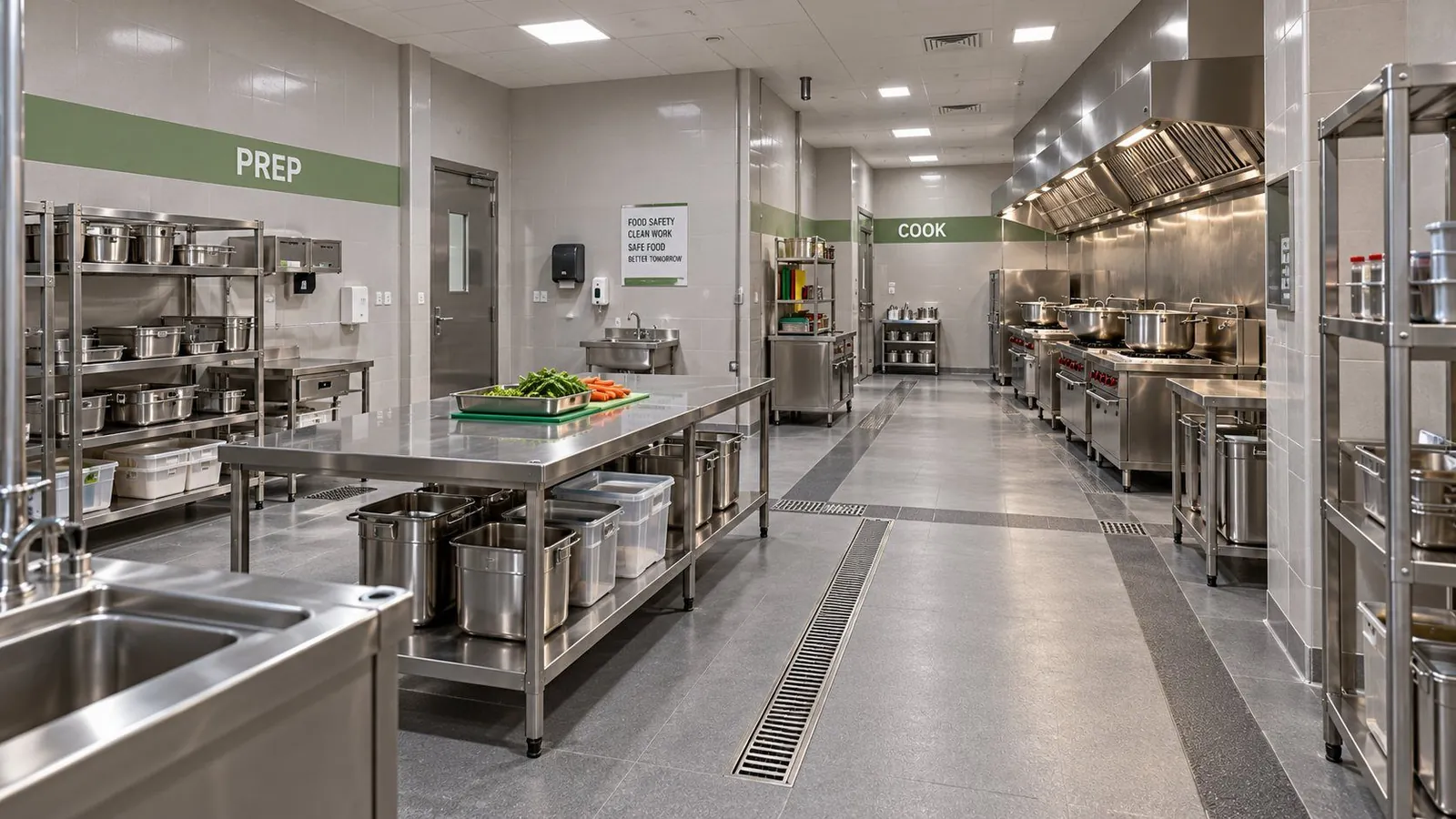

Commercial canteen kitchen with stainless-steel prep tables, racks, a cooking line under an extract hood and a floor drain
Kitchen: preparation in front, the cooking line under its hood beyond, a slot drain along the route. Indicative viewpoint.

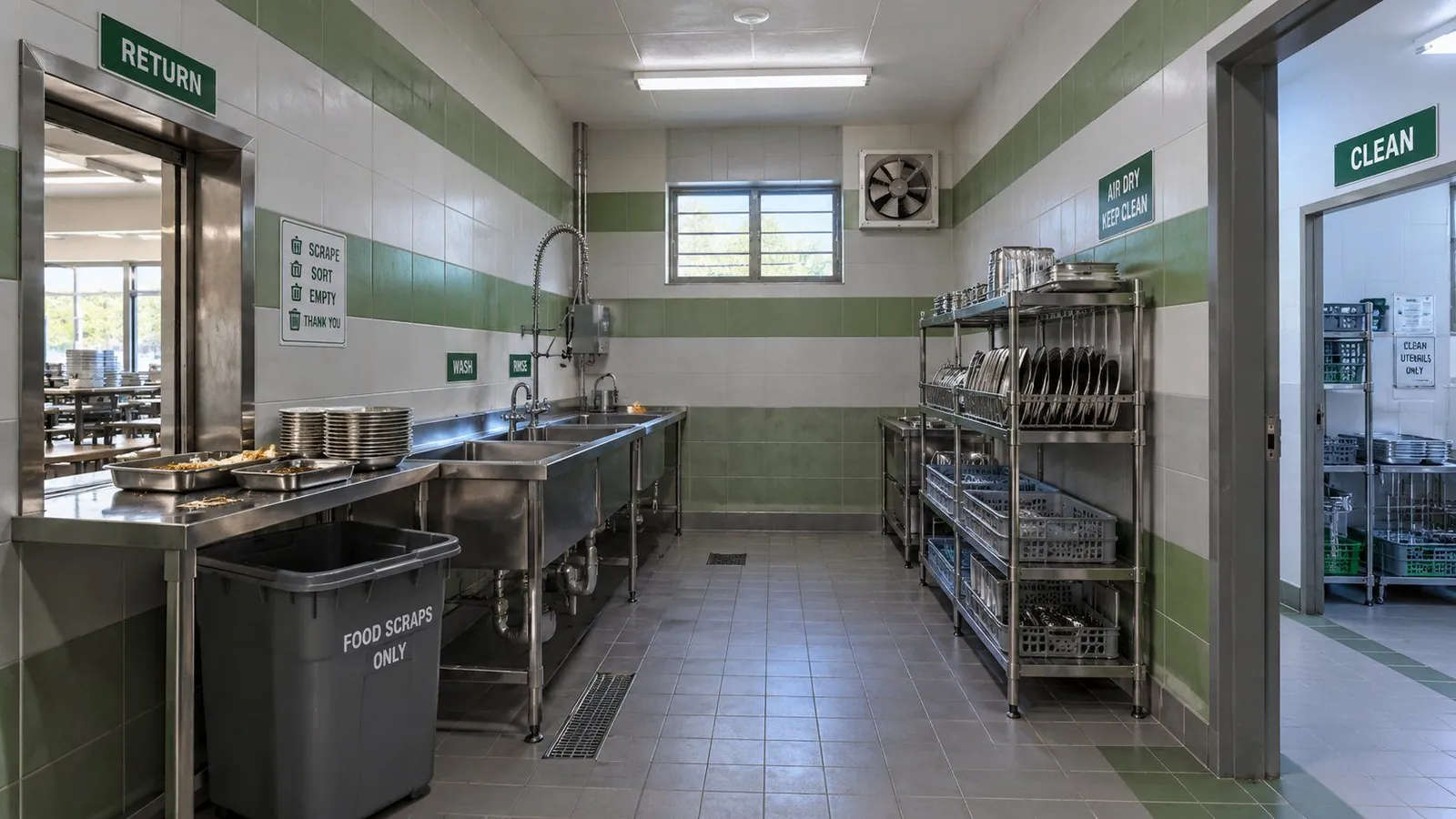

Dish-return room with a return hatch, a food-scraps bin, a three-bowl sink with spray rinse and drying racks
Dish return: scrape, wash, rinse and dry in one line, then out through a separate clean door. Indicative viewpoint.

Welfare rooms

A daycare, with its own feeding room and washroom, shares the ground floor with the dining halls and the health centre.

Daycare room with small round tables and chairs, toy shelves, painted bird and plant murals and a glazed door
Daycare beside the canteen, with its own feeding room and washroom off it. Indicative viewpoint.

Frequently asked

Split the seats so no hall is too large to manage at a shift break, and put a servery against each hall. This plan has a 156-seat and a 194-seat hall on the ground floor, either side of the entrance corridor, and a 320-seat hall above. Each hall has its own servery wall, drop-plate point and dish wash, so a queue never crosses from one hall into another and the upstairs hall does not depend on trays carried up the stair.

Because the building already has what a training room needs: a large clear floor, toilets, drinking water and a place to eat between sessions. Here the first floor shares the building with a classroom-and-round-table training room and a product gallery. Trainees can break for a meal next door rather than walk across the site, and the training room can seat a full intake without taking space from the plant.

Hard, matt and easy to wash, and different in dry and wet rooms. This design uses grey and green Kota stone in the dry dining areas, with colour-matched matt porcelain in the handwash rooms, toilets and kitchen. Laying both in whole rectangular modules and setting out from the surveyed room edges avoids slivers of cut tile at the walls, which are what crack and lift first.

The junctions. Waterproofing turned up at the wall, sealant at every change of plane, a matt floor tile laid to fall towards the drain, a flush transition at the doorway so trolleys do not catch, and traps and fittings that can be reached and replaced. In this concept these are shown as schematic junctions; the actual falls, outlets and waterproofing are settled in coordinated working drawings.

So the choice is about colour and character, not about layout. All five options keep the same halls, servery, kitchen and wet rooms, the same 300 x 600 mm stock wall tile and the same floor approach. What changes is the paint above the dado, the chair colour, the tile banding and the mural theme. That keeps the decision quick and the cost difference between options small.

Yes. Send the site plan, the shift pattern and the largest number eating at one time, plus any welfare rooms the site needs, and we will plan the halls, the kitchen flow and the support rooms together, then build the shell, interiors and services as one package.
